Amogh N P
 In loving memory of Amogh N P — Architect · Designer · Visionary 
Scope Boundaries — Architect, Interior Designer & Contractor
Construction

Scope Boundaries — Architect, Interior Designer & Contractor

The Architects Act 1972, the IIID Code, BOCW 1996 & RERA 2016 — Stage-by-Stage Role Map, Hot Boundary Zones, Liability Matrix, and the Tri-Party Contracting Discipline for Indian Residential Practice

23 min readAmogh N P8 May 2026

Indian residential architecture is practised in a triangle. At the apex sits the architect — the only role with a statutory identity under the Architects Act 1972 and the only signature that authorises a building plan. Adjacent are two roles whose presence is no less material to the finished building: the interior designer, whose discipline is governed by no statute and no compulsory register, and the contractor, whose practice is regulated under labour and tax law but not under any design-credentialing framework. The three roles overlap, intersect, and — in poorly contracted projects — collide. The architect who wishes to practise residential architecture in India in 2026 with predictable outcomes must hold an unambiguous map of where the architectural scope ends and the other two scopes begin.

This guide is the architect's working map. It is the practitioner's-side counterpart to the homeowner-facing How to Choose the Right Architect or Interior Designer guide; that guide tells the prospective client how to pick among the three roles, this guide tells the architect already on the project how to negotiate scope, draft contracts, supervise execution, and allocate liability across the boundary lines. The orientation throughout is towards Indian residential practice — independent houses, villas, apartment renovations, small redevelopments — at scales typical of independent-architect and small-studio engagements.

The treatment is operational. The Architects Act 1972 (with the COA Code of Conduct of Architects, 1989), the Indian Institute of Interior Designers (IIID) charter, the Building and Other Construction Workers (Regulation of Employment and Conditions of Service) Act 1996, the Real Estate (Regulation and Development) Act 2016, the Indian Contract Act 1872, and the relevant Indian Standards form the underlying authority; this guide describes how they intersect in residential projects where two or three of these roles are simultaneously engaged.

"In Indian residential architecture, the most consequential drawings are not the plans — they are the scope-of-work tables in the engagement letters. Most disputes are not design failures; they are boundary failures the contracts did not foresee." — Common observation in construction-arbitration practice


1. Why the Boundary Question Matters

The boundary question matters because failure of boundary discipline is the second-most-common cause of residential project failure in India, behind only undisclosed budget constraints. The project-failure causal map traces twelve recurring failure modes; six of them — scope-creep without change orders, undocumented design-build conversion, simultaneous-execution conflicts, FF&E gaps at handover, waterproofing-spec disputes, and false-ceiling-MEP collisions — are direct consequences of unmapped role boundaries.

The boundary problem in 2026 has three structural causes:

  • Statutory asymmetry. The architect is a statutorily-defined profession (Architects Act 1972, §37 — only a registered architect may use the title and authenticate building plans). The interior designer has no equivalent statutory definition — IIID membership is voluntary, and design-school qualifications (NID, CEPT, Pearl, Symbiosis, JJ School) are recognised by employers but not by law. The contractor sits outside design law entirely, regulated instead under BOCW 1996, GST, MSME, and (where applicable) RERA 2016.

  • Market overlap. All three roles offer overlapping services to the homeowner. An architect may offer interior fit-out. An interior designer may offer "design-build" with an in-house construction team. A contractor may offer "turnkey" with an in-house designer. The homeowner — typically not equipped to distinguish — chooses on price and word-of-mouth.

  • Convention drift. Indian residential conventions have drifted from the international norm of architect-coordinated tri-party engagement towards two ends — the cheaper contractor-led end (especially in tier-2 cities) and the interior-designer-led end (especially in metro apartment renovations). In both, the architect's coordinating role is reduced or absent, and statutory accountability becomes ambiguous.

The architect's professional response is not to lobby for monopoly but to bring boundary discipline to whatever pattern the project is contracted under. The map below is the discipline.

Three-role overlap — Architect, Interior Designer, Contractor — flat-lay of the contract triangle showing the statutory anchor, the regulated zone, and the contested boundary regions

2. The Three Roles — Statutory and Functional Definitions

2.1 The Architect

DimensionArchitect (statutory)
Statutory frameworkArchitects Act 1972; Council of Architecture Rules 1989; COA Code of Conduct 1989; State amendment notifications
Title protectionYes — §37 reserves the title "Architect" to COA-registered persons
Plan authenticationMandatory — only an architect may sign and submit building plans for sanction across most Indian states
Minimum qualificationB.Arch (5 years) from a COA-recognised institution; mandatory COA registration
Continuing professional developmentCOA CPD framework
Code of conductCOA Code of Conduct 1989 — specifies professional duties, advertising restrictions, fee minimums (advisory), conflict-of-interest
Professional indemnityVoluntary; recommended; many state-government projects mandate
Tax registrationGST (services HSN 998321 — architectural services)
Liability horizon10 years for major structural defects under tort + Architects Act §22; lifetime for fraud

The architect's scope of services is canonically defined in the COA Conditions of Engagement and Scale of Charges 2020 across nine stages from concept to post-construction. The full canonical scope is outside this guide; what matters here is what the architect alone is empowered to do, which is plan authentication, statutory submissions, and structural design oversight (in coordination with the structural consultant).

2.2 The Interior Designer

DimensionInterior Designer (functional)
Statutory frameworkNone — no Indian statute defines, registers, or regulates interior designers
Title protectionNo — anyone may call themselves an "Interior Designer"
Plan authenticationCannot sign building plans for sanction; can sign FF&E specifications and interior layouts as project documents
Voluntary professional bodyIIID — Indian Institute of Interior Designers (since 1972); membership signals professional commitment
Typical qualificationsB.Des (Interior Design), B.Arch with interior specialisation, NID PG Diploma, CEPT Interior Design, Pearl Academy, Symbiosis, JJ School of Art; some practising designers are self-taught with strong portfolios
Code of conductIIID Code of Ethics (voluntary, applies only to members)
Tax registrationGST (services HSN 998391 — interior decorating services)
Liability horizonContract-based (typical 3–5 year defect liability), and tort-based for negligence; no statutory minimum

The absence of a statutory framework means the interior designer's scope is whatever the contract says it is. This is freedom and risk in equal measure: the role can be tightly scoped to FF&E and finishes, or broadly scoped to include layout, MEP coordination, and even (in design-build firms) construction management. The architect's discipline is to ensure the scope is named, not assumed.

2.3 The Contractor

DimensionContractor (regulated, not credentialed)
Statutory frameworkBOCW Act 1996 (workers); Indian Contract Act 1872; CGST/SGST Acts; State Shops & Establishments; RERA 2016 (where promoter-status applies); state Builders' Licensing Acts (Karnataka, Maharashtra, others)
Title protectionNo design-related title protection; "Builder" is regulated only where state Builders' Licensing applies
Plan authenticationCannot — must execute per architect-authenticated plans
Voluntary professional bodiesCREDAI (developers), Builders' Associations (state-level)
Typical qualificationsNo formal requirement; civil engineering background common at the engineer level; site-supervisor diplomas (NTC, NSDC) common
Tax registrationGST mandatory above ₹20 lakh turnover; MSME registration recommended; PF/ESI for workers; labour cess (1% of project cost) under BOCW
Liability horizonContractual defect-liability period (typical 12–24 months for residential); 10 years tort liability for major structural defects

The contractor's scope is execution — building the structure that the architect has designed and the IDs has finished, in compliance with the IS codes, NBC, and contract specifications. Where the contractor offers "design-build" or "turnkey," the contractor is contracting on behalf of an architect (whose seal must still authenticate the plan submission) and an interior designer (whose finishes selection is being delegated). The architect's discipline is to confirm those internal credentials before agreeing to be the plan-signing architect for a contractor-led design-build engagement — see §7.3.


3. The Stage-by-Stage Scope Map

The most useful single artifact in this guide is the stage-by-stage role table. The table answers, for each project stage, three questions: who is primary (deliverable owner), who is secondary (input/coordination), and who is out of scope.

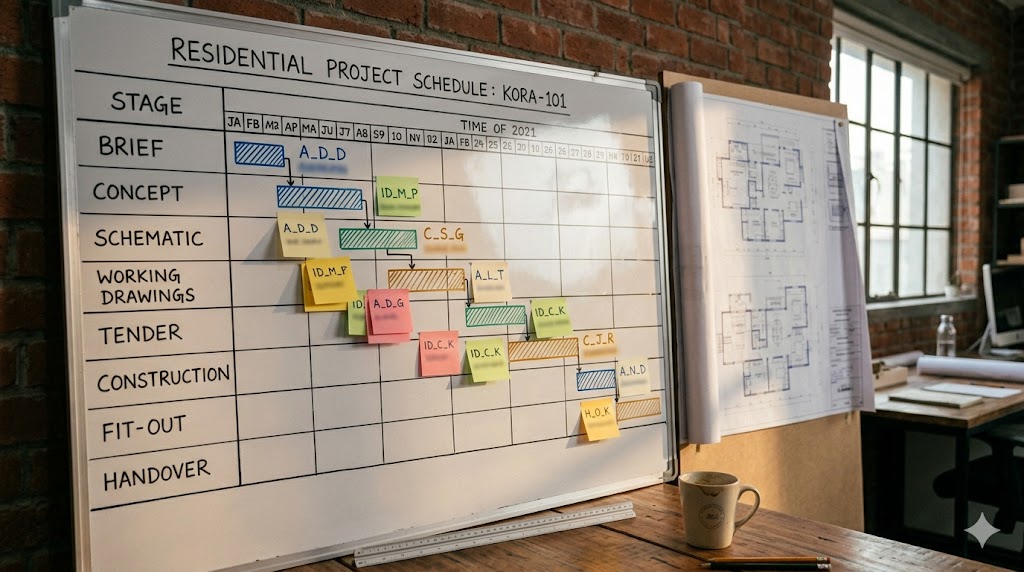

Project-stage role map — wall-mounted Gantt board in a Bengaluru architect's studio, eight residential stages with handwritten architect / interior designer / contractor role assignments in coloured marker

Stage 0 — Brief & Site Due Diligence

ActivityPrimarySecondaryOut of Scope
Client brief captureArchitectInterior Designer (if interior scope present)Contractor
Site survey, soil investigationArchitect (commissions)Contractor
Title verification, regulatory due diligenceArchitect (or client's lawyer)Designer, Contractor
Budget feasibilityArchitectInterior Designer (FF&E layer)Contractor (rates input only)
Programme & scope-of-services agreementArchitectDesigner (own scope), Contractor (own scope)

Boundary discipline: The architect's brief must include the interior designer's brief and the contractor's brief, as separate but linked documents. Scope confusion at Stage 0 propagates through all later stages.

Stage 1 — Concept Design

ActivityPrimarySecondaryOut of Scope
Concept massing, plan partiArchitectDesigner, Contractor
Spatial brief — room sizes, adjacenciesArchitectInterior Designer (input on functional FF&E volumes)Contractor
Material vocabulary (early)ArchitectInterior Designer (interior surfaces)Contractor
Concept renderingsArchitect (exterior + spatial)Interior Designer (interior moodboards)Contractor

Boundary discipline: Even when an interior designer is engaged from Day 1, the spatial brief is the architect's deliverable; the IDs's input is on FF&E-driven volume requirements (e.g., a walk-in wardrobe of specific dimensions, a kitchen layout that works with a specific appliance set).

Stage 2 — Schematic Design & Statutory Submission

ActivityPrimarySecondaryOut of Scope
Schematic plans, sections, elevationsArchitectDesigner, Contractor
FAR/setback compliance, plan sanctionArchitectDesigner, Contractor
Statutory submissions (BBMP / MCGM / equivalent)ArchitectDesigner, Contractor
Structural conceptArchitect (commissions structural engineer)Structural EngineerContractor
Interior space-planning inputInterior Designer (input)Architect (incorporates)Contractor

Boundary discipline: The plan-sanction package is the architect's exclusive responsibility. Interior designers must not "tweak the plan" after sanction without architect-authored revisions — every post-sanction plan modification must be revisioned and re-submitted where required (see OC/CC and Plinth Verification).

Stage 3 — Working Drawings & Detailed Design

ActivityPrimarySecondaryOut of Scope
GFC architectural drawingsArchitectDesigner, Contractor
Structural GFCStructural Engineer (under architect coordination)ArchitectContractor
MEP GFCMEP Consultant (under architect coordination)Architect, Interior Designer (FF&E loads)Contractor
Interior detail drawingsInterior DesignerArchitect (compliance review)Contractor
FF&E specificationInterior DesignerArchitect (compliance review)Contractor
Specification & material schedules (architectural)ArchitectInterior Designer (interior layer)Contractor
Bill of Quantities (BoQ)Architect (or QS engaged by architect)Interior Designer (interior items)Contractor (rates input only)

Boundary discipline: Working drawings must be coordinated. Architect and interior designer must not produce conflicting drawings of the same space — the architect's reflected ceiling plan and the IDs's reflected ceiling plan, for example, must be reconciled into a single drawing under one author. Working Drawings Documentation explains the discipline; the practical rule is one author per drawing, with the other role signing off on coordination.

Stage 4 — Tender, Procurement & Contract Award

ActivityPrimarySecondaryOut of Scope
Main contractor tenderArchitectDesigner
Specialist contractor tender (interior, FF&E)Interior DesignerArchitect (compliance review)
Contract draftingArchitect (with client's lawyer)Contractor (proposes only)
Risk allocation & contingencyArchitect
FF&E procurementInterior DesignerContractor

Boundary discipline: Risk allocation is the architect's contractual responsibility. The Contingency, Provisional Sums & Risk Allocation guide details the eight Indian-specific risks and the model contract clauses; the boundary point here is that the architect cannot delegate risk allocation to the contractor without losing professional control of the project economics.

Stage 5 — Construction Supervision

ActivityPrimarySecondaryOut of Scope
Site visits & inspectionArchitectInterior Designer (interior stages)Contractor (executes)
Quality control of structural workArchitect (with structural engineer)Contractor
RA bill verification & certificationArchitectContractor (raises)
Material approval (architectural)ArchitectInterior Designer (interior layer)Contractor (proposes)
Material approval (interior)Interior DesignerArchitect (compliance review)Contractor (proposes)
Coordination of site clashesArchitectAll roles

Boundary discipline: The architect retains the certification role for RA bills; the interior designer may certify the interior fit-out RA layer separately, but the architect's final certificate covers the whole project. The Site Supervision Checklist covers the 200+ inspection items the architect and IDs share.

Stage 6 — Interior Fit-Out, FF&E Installation

ActivityPrimarySecondaryOut of Scope
False ceiling, lighting, AVInterior DesignerArchitect (compliance review), MEP ConsultantContractor (executes)
Modular kitchen, wardrobe installationInterior DesignerArchitect (electrical/water-point compliance)Contractor (provides infra)
Furniture (built-in)Interior DesignerContractor
Furniture (loose)Interior Designer
Soft furnishings, curtains, artInterior Designer
Final finish coordinationInterior DesignerArchitect (sign-off)Contractor (executes)

Boundary discipline: Stage 6 is the IDs's stage. The architect's role narrows to compliance review — confirming that interior modifications do not violate statutory or structural conditions. Stage-6 decisions made without architect review are the most common origin of post-handover disputes (cf. §6 hot-boundary zones).

Stage 7 — Handover & Post-Occupancy

ActivityPrimarySecondaryOut of Scope
Snagging & punch listArchitect (master) + Interior Designer (interior layer)Contractor (rectifies)
OC applicationArchitectDesigner, Contractor
BWSSB / BESCOM / equivalent connectionsArchitectDesigner, Contractor
Handover of as-built drawingsArchitectInterior Designer (interior as-built)Contractor (input)
Defect-liability period managementArchitectInterior Designer (interior layer)Contractor (rectifies)
Post-occupancy review (12 months)ArchitectInterior Designer

Boundary discipline: The architect retains the OC and statutory close-out responsibility. Snagging and punch list are joint architect-IDs deliverables — see the Snagging & Punch List Standards guide (forthcoming companion) for the detailed protocol.


4. Five Hot-Boundary Zones

The stage map above is the normal case. In every Indian residential project, however, there are five recurring zones where the boundaries blur and where most boundary disputes originate. The architect's discipline is to name these five zones explicitly in the engagement letter — not as exceptions but as standard scope items.

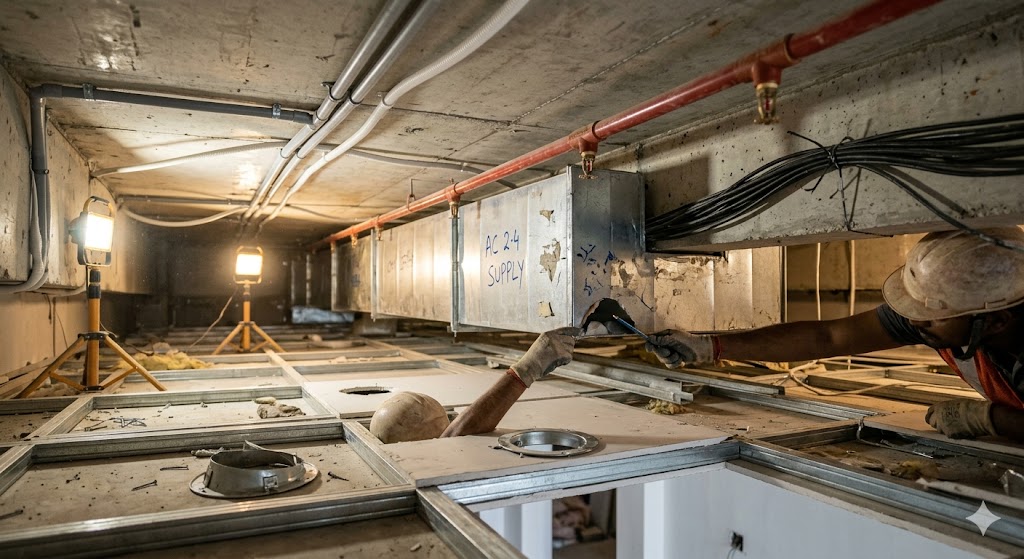

Hot-boundary zone — inside-the-cavity view of a partially-installed gypsum false ceiling on a residential site, AC duct, sprinkler line, electrical conduits and recessed downlight cut-outs converging in 250 mm of vertical service zone

4.1 False Ceilings, Lighting, AV

The zone: The 100–300 mm depth between structural slab soffit and finished ceiling — where AC ducting, electrical conduits, sprinkler runs, recessed lighting housings, AV cabling, and structural beams compete for space.

The boundary problem: The interior designer designs the visible ceiling pattern (cove lights, recessed downlights, decorative bulkheads) without site-coordination access to the MEP layouts; the MEP consultant runs ducts to the most efficient path without seeing the IDs's lighting plan; the architect signs off on the reflected ceiling plan but rarely re-coordinates after IDs revisions.

The discipline: Reflected ceiling plan is one drawing, not three. The architect or IDs is the single author; the other reviews. The MEP consultant's services drawings overlay the RCP. Site-stage clash resolution is the architect's call — not the contractor's improvisation.

Liability: Cracks at gypsum-MS joints from improperly distributed ceiling loads, AC condensation drips through over-cut lighting cut-outs, and sprinkler activation through poor duct-light coordination are all liability events. The architect carries primary liability if the RCP was not coordinated; the IDs carries shared liability if the IDs revised the plan post-coordination without re-review.

4.2 Modular Kitchens & Wardrobes

The zone: The interface between built-in modular furniture (kitchens, wardrobes) and the surrounding architecture — wall finishes, electrical points, water/drainage points, exhaust outlets, ventilation.

The boundary problem: The IDs (or the modular vendor — IKEA, Sleek, Häfele, Godrej Interio) designs the modular layout late in the project; the architect's electrical and plumbing GFC was finalised based on a different layout; site-stage rework includes chasing walls for additional points, drilling cores for chimney exhausts, or relocating water lines.

The discipline: Modular kitchen and wardrobe layouts must be locked at GFC stage, not at fit-out stage. If the homeowner has not finalised the modular vendor by GFC, the architect provides a generic kitchen and wardrobe brief with provisional points and a 10–15% contingency for relocation. The IDs's brief includes a deadline for vendor finalisation matched to the GFC milestone.

Liability: Late-stage relocation of plumbing or electrical points that compromises waterproofing, structural rebar, or fire-stopping is a serious liability event. The IDs carries primary liability if the relocation was IDs-instructed without architect review; the architect carries shared liability if the GFC was permitted to proceed with insufficient kitchen/wardrobe definition.

4.3 Wet-Area Waterproofing & Sanitary Fittings

The zone: Bathroom, kitchen, balcony, terrace — wherever water and finishes meet.

The boundary problem: Three roles overlap here. The architect specifies the waterproofing system (membrane type, IS code reference — IS 12200, IS 8543, IS 13182 — bond-coat, fall-direction). The interior designer specifies the sanitary fixtures, tile pattern, and finish details. The contractor executes both. When water leaks appear at month 18, the question is whose specification was inadequate or whose execution failed.

The discipline: The waterproofing specification is the architect's, not the IDs's, even if the tile and fixture choices are the IDs's. The architect's drawings must show waterproofing extent (typically 1.8 m vertical in showers, full floor + 300 mm vertical elsewhere), membrane brand/grade, fall direction, and bond-coat detail. The IDs's drawings must show tile coursing, niche locations, and fixture positions but cannot override the waterproofing specification.

Liability: Refer to the waterproofing guide; the liability split is architect-specification, contractor-execution. The IDs carries liability only if IDs-led changes to fixture or tile layout compromised the specification (e.g., a niche cut into a waterproofed wall without re-membraning).

4.4 Façade Lighting & Landscape

The zone: Exterior building face, terrace gardens, courtyards, driveways.

The boundary problem: Architects design the façade and the major landscape; interior designers sometimes propose façade lighting (especially for premium residential where the IDs's brief includes "exterior ambience"); landscape consultants — when engaged — operate as a fourth role with their own drawings; contractors execute. Lighting on the façade interacts with electrical safety codes (IS 732, NBC Part 8) that the IDs may not be familiar with.

The discipline: Façade and landscape are within the architect's scope by default. If the IDs's contract includes façade lighting, the IDs's design must be reviewed and approved by the architect for code compliance and aesthetic coherence with the architectural intent. A separate landscape consultant, when engaged, is contracted by the architect or by the client through the architect's coordination — never separately to the IDs.

Liability: Electrical hazards from non-IS-732-compliant outdoor wiring are architect-and-contractor liability events. Aesthetic inconsistency between IDs-led façade lighting and architectural intent is a contractual disagreement, not a liability event.

4.5 FF&E (Furniture, Fixtures & Equipment) at Handover

The zone: Loose furniture, soft furnishings, art, plants, kitchen appliances, electronics, curtains.

The boundary problem: FF&E is unambiguously the IDs's scope when an IDs is engaged. When no IDs is engaged, FF&E falls into a gap — the architect's contract typically excludes FF&E, the contractor's scope ends at fit-out, and the homeowner is left to source independently. The result, in many no-IDs projects, is a finished house at 95% completion that "doesn't feel finished" because curtains, lighting fixtures, and furniture are missing or mis-scaled.

The discipline: The architect's engagement letter must explicitly state whether FF&E is in scope, partially in scope, or out of scope. If out of scope, the architect must advise the client to engage an IDs for FF&E or to budget time and expertise for self-procurement. The architect's scope is not extended implicitly into FF&E by the absence of an IDs.

Liability: None — FF&E is contractual, not liability-driven. The risk is reputational (an architect's project that "feels unfinished" reflects on the architect's reputation regardless of the contracted scope).


5. The Liability Matrix

Liability across the three roles is allocated by a combination of statute, common-law tort, and contract. The matrix below summarises the primary, secondary, and shared liability for the recurring failure modes.

Liability matrix — twelve common failure modes, with primary liability owner, shared parties, and the statutory or contractual basis for the allocation
Failure ModePrimarySharedBasis
Structural collapse, major crackingArchitect (with structural engineer)Contractor (workmanship)Architects Act §22, COA Code §2.3, tort negligence
Code violation (FAR, setback, height)ArchitectContractor (if executed beyond plan)Statutory; municipal action
Plinth-level non-complianceArchitectContractorArchitects Act, BBMP/MCGM bye-laws
Waterproofing failure (specification)ArchitectContract; IS 12200 reference
Waterproofing failure (workmanship)ContractorArchitect (supervision)Contract; defect-liability period
Electrical safety (IS 732 non-compliance)Architect (specification) + Contractor (execution)Statutory; tort
MEP-architectural clashArchitectMEP ConsultantContract; coordination clause
RCP coordination failureArchitectInterior Designer (if IDs-revised)Contract; coordination clause
Modular kitchen / wardrobe reworkInterior DesignerArchitect (if GFC inadequate)Contract
FF&E mis-spec or missingInterior Designer (if engaged)Contract
Cost overruns (legitimate)Shared per change-order disciplineContract; Contingency guide
Cost overruns (scope creep, undisclosed)Whoever instructed without change orderContract; tort (breach of fiduciary duty)

The matrix is not exhaustive but covers the twelve most common failure-allocation questions in residential arbitration. The architect's discipline is to internalise this matrix at engagement — not to memorise it but to ensure that the engagement letter and the contract framework reflect it.


6. Four Contractual Patterns

Indian residential projects are typically contracted under one of four patterns. Each has implications for boundary clarity, coordination cost, and liability allocation.

6.1 Single-Point Architect (architect-led)

The architect is contracted by the client for the full scope — architecture, interior design, contractor selection, and supervision. The IDs and contractor are sub-contracted by the architect (or by the client through the architect's coordination).

AspectSingle-Point Architect
Client contractsArchitect only
CoordinationArchitect coordinates IDs and contractor
LiabilityConcentrated on architect (deepest pocket exposure)
FeesArchitect ~10–15% of project cost; IDs and contractor sub-fees within architect's umbrella or separately quoted
Best forPremium residential where the client values single-point accountability
RiskArchitect's single-point liability is high; PI insurance essential

6.2 Tri-Party (parallel engagement, architect-coordinated)

The client contracts each of the three roles independently. The architect's contract includes a coordination clause that gives the architect coordination authority across the IDs and contractor scopes without contractual privity.

AspectTri-Party
Client contractsArchitect, IDs, Contractor — all separately
CoordinationArchitect coordinates by clause, not contract
LiabilityDistributed; each role liable for own scope
FeesArchitect ~6–10%; IDs ~4–8%; Contractor PMC ~3–5%
Best forMid-to-large residential where client wants distributed accountability
RiskCoordination friction; architect's coordination authority must be contractually anchored

This is the most common pattern for sophisticated residential clients in 2026 and the pattern this guide implicitly assumes. The coordination clause is the linchpin — see §7.

6.3 Design-Build (turnkey)

A single firm — typically a contractor with in-house design or an IDs with in-house construction — offers full delivery. The architect, where present, is engaged by the design-build firm (not the client) and signs the building plan submission.

AspectDesign-Build
Client contractsDesign-build firm only
CoordinationDesign-build firm coordinates internally
LiabilityConcentrated on design-build firm; architect liable for plan compliance only
FeesBundled; opacity of fee split is a known concern
Best forBudget-driven small residential where client wants single-vendor simplicity
RiskArchitect's plan-signing without design control is professionally hazardous; only legitimate if the architect has full design authority within the design-build firm and is a credentialed in-house architect, not a hired-signature

Architects approached to "sign the plan only" for design-build firms should refuse — see the plan-signature-only prohibition under COA Code of Conduct §2.7 (professional services to be performed personally; no certificate to be issued for work not personally supervised).

6.4 PMC Overlay (Project Management Consultant)

The architect, IDs, and contractor are engaged separately (as in tri-party), and a PMC is added as a fourth role with formal coordination authority across all three.

AspectPMC Overlay
Client contractsArchitect, IDs, Contractor, PMC — four parties
CoordinationPMC coordinates by formal contract authority
LiabilityDistributed; PMC liable for coordination failures
FeesAdds 3–5% of project cost as PMC fee
Best forLarge residential (₹5+ crore) where coordination complexity warrants a dedicated role
RiskCost overhead; risk of architect/PMC scope conflict; only justified at scale

Recommendation. For most residential projects in 2026, tri-party with a strong coordination clause is the optimal pattern. The architect's coordination authority is contractually anchored; the IDs and contractor maintain their own liability horizons; the homeowner has tri-party visibility without a four-party coordination overhead.


7. The Coordination Clause — Drafting Discipline

The coordination clause is the contractual instrument that anchors the architect's authority to coordinate across the IDs and contractor scopes in a tri-party engagement. A weak coordination clause leaves the architect with responsibility but no authority — the worst contractual position. A well-drafted clause defines what the architect can do, what the architect cannot do, and what happens when the IDs or contractor disagrees.

Minimum elements of a coordination clause:

1. Recital of tri-party engagement — naming the IDs and contractor and acknowledging that all three are engaged separately by the client.

2. Scope of architect's coordination — RCP coordination, MEP-IDs clash resolution, schedule integration, RA bill review, change-order review, defect-liability coordination.

3. Architect's reasonable instructions — IDs and contractor agree to comply with architect's reasonable instructions on coordination matters; reasonable defined as consistent with the architect's authenticated drawings and specifications.

4. Dispute resolution — disagreement between IDs and architect or contractor and architect on coordination is referred to the client; the client's decision binds both, and the architect's coordination role continues unaffected.

5. No usurpation of design authority — the architect's coordination authority does not extend to override the IDs's design choices within the IDs's scope, or the contractor's execution methods within accepted standards.

6. Coordination meeting cadence — weekly during construction, fortnightly during fit-out, monthly during DLP.

7. Coordination documentation — architect maintains the coordination minute-book; minutes are circulated to all three roles within 3 working days.

8. Compensation for coordination scope creep — additional coordination demands beyond the agreed scope (e.g., daily site presence) trigger a documented variation.

The full draft language is outside this guide's scope; the Contract Template utility generates a compliant template, and the Risk Index flags coordination-clause weaknesses.


8. Twelve-Test Diagnostic — Before Signing the Engagement

Before the architect signs the engagement letter for any multi-role residential project, the following twelve tests should pass. Failing any test is not necessarily a deal-breaker, but the failure must be remedied or formally accepted before scope-of-services is locked.

TestQuestionPass Criterion
1Is the contractual pattern explicitly named?Single-point / tri-party / design-build / PMC overlay — chosen and documented
2Is the IDs engaged, named, and qualified?If yes — IDs's qualifications and contract scope reviewed; if no — FF&E scope explicitly stated
3Is the contractor selected, and on what basis?Selection criteria, qualifications, and contract scope reviewed
4Has the COA registration of the architect and CoA-recognised education been verified?COA verification confirmed for record
5Is the coordination clause drafted and accepted by IDs and contractor?Clause language reviewed; signed acknowledgment recorded
6Is the FF&E scope explicitly named (in / partial / out)?Engagement letter contains explicit FF&E clause
7Is the fee split agreed and acknowledged by the client?Fee schedule and stage milestones documented
8Is the change-order discipline named (cf. Contingency guide)?Change-order process documented; contingency provisions stated
9Is the coordination meeting cadence agreed?Weekly / fortnightly / monthly cadence stated
10Is the defect-liability period agreed across all three roles?DLP terms documented; rectification protocol stated
11Is professional indemnity insurance confirmed for the architect and (where applicable) the IDs?PI policy active and disclosed
12Is the scope-creep escalation path defined?Architect / IDs / contractor → client → arbitration sequence stated

Architects who sign engagements with three or more failing tests have an above-average probability of project disputes. The Red Flag Checklist operationalises this diagnostic.


9. Indian Regulatory Anchors — Quick Reference

SourceAuthority overRelevance
Architects Act 1972Architects (statutory)Defines the profession; reserves the title; requires COA registration
COA Code of Conduct 1989ArchitectsProfessional duties; advertising restrictions; conflict of interest; minimum service standards
COA Conditions of Engagement and Scale of Charges 2020ArchitectsCanonical scope of services across nine stages; fee minimums (advisory)
IIID Code of EthicsInterior Designers (members only)Voluntary professional code; not statutorily binding on non-members
BOCW Act 1996Construction workers and contractorsWorker registration, labour cess (1% of project cost), safety standards
RERA 2016Real-estate promotersPromoter registration (above 500 sqm or 8 units); applies to multi-unit residential, not owner-occupier homes
Indian Contract Act 1872All contracted partiesFoundational law of contract; coordination clause enforceability
NBC 2016All constructionNational Building Code; structural, fire, plumbing, electrical, lifts
IS 12200 / IS 8543 / IS 13182WaterproofingSpecification basis for wet-area waterproofing
IS 732ElectricalCode of practice for electrical wiring installations
IS 4963 / NBC Part 3 §13Universal designAccessibility specifications; cf. Universal Design guide
State Builders' Licensing ActsContractors (in some states)Karnataka Builders' Licensing, Maharashtra equivalent — registration and class-of-work limits

10. Common Boundary Disputes — Resolution Patterns

DisputePattern That Resolves It
IDs revised RCP without architect re-review; ducts now clashCoordination minute referencing original RCP; IDs to bear cost of resolution since revision was unilateral
Contractor executed wall slot for kitchen exhaust without architect review; structural concern raisedContractor to bear cost; architect's site-supervision clause invoked; structural engineer review required before further work
Client added FF&E demands mid-project; IDs claims out-of-scopeEngagement-letter FF&E clause referenced; if FF&E was named partial or out, client must engage IDs for the additional scope or accept architect-coordinated procurement assistance as a variation
Modular kitchen vendor finalised post-GFC; rework neededArchitect's GFC-deadline clause referenced; client / IDs to bear rework cost; architect's compliance review of revised points required
Waterproofing failure at month 18Investigation: was specification adequate (architect liable) or workmanship (contractor liable)? Contract DLP clause invoked; investigation by independent third-party recommended
Cost overrun, IDs blames architect's GFC quality, architect blames IDs's scope creepCoordination minute book and change-order log reviewed; whichever role instructed work without documented change order bears the cost
Façade lighting design by IDs violates IS 732Architect's compliance-review veto; IDs to revise; cost of revision borne by IDs

The pattern is consistent: the engagement letter and the coordination minute book are the primary evidence in any boundary dispute. Architects who maintain disciplined documentation almost always prevail in arbitration; architects who rely on informal coordination almost always lose contested positions.


11. Operational Workflow — A Day in the Life of Boundary Discipline

Boundary discipline is not a one-time engagement-letter event. It is a daily practice. The following workflow reflects what disciplined boundary-aware practice looks like in a typical residential project at month 8 — fully into construction, with fit-out planning underway.

Monday-morning weekly site coordination meeting in a residential project's site cabin — architect at the printed reflected-ceiling-plan, interior designer with material binder, contractor's project manager with the BoQ, MEP consultant with thermal-load printouts, marked-up drawings on the plywood wall

Monday 09:30 — Weekly site coordination meeting. Architect chairs; IDs's representative, contractor's project manager, MEP consultant attend. Agenda: prior-week site progress, current-week schedule, RA bill status, material approvals pending, RFIs (Requests for Information), change orders pending. Architect's site engineer takes minutes; minutes circulated by EOD Tuesday.

Tuesday 11:00 — Architect reviews IDs's revised RCP for the master bedroom (IDs proposed a cove-light addition). Architect identifies clash with AC duct routing; sends to IDs with redlined drawing requesting revision. Coordination minute logged.

Wednesday 14:00 — Site visit. Architect observes contractor has pre-cast a wall slot for the kitchen exhaust per IDs's modular-kitchen-vendor's specification. Slot was not on the architect's GFC. Architect halts work, calls structural engineer for review. Notice issued to contractor. Meeting scheduled with IDs and modular vendor for Friday.

Thursday 10:00 — Change-order review. Three change orders pending — IDs-instructed cove-light addition (cost ~₹35,000), client-instructed marble upgrade in living room (cost ~₹2,40,000), and contractor-instructed substitution of cement brand (cost neutral but specification deviation). Architect reviews each, updates the change-order log, computes contingency drawdown. Client copy circulated.

Friday 15:00 — Friday review with client. Architect summarises week's coordination, flags the kitchen-exhaust slot incident, presents change orders for client decision. Client approves cove-light, defers marble upgrade pending budget review, approves cement substitution. Decisions logged in the change-order register.

This is the pattern. Boundary discipline is a paperwork discipline. The architect who maintains the coordination minute book, the change-order register, and the RFI log is the architect whose projects close on time with predictable economics. The architect who delegates these to the contractor or the IDs has, in effect, delegated authority and retained only liability — the worst position.


12. Companion Studio Matrx Guides

Companion Studio Matrx Tools


13. References

Primary Statutes and Codes

  • Architects Act 1972 (Act No. 20 of 1972) — establishment of the Council of Architecture; reservation of the title; registration framework.
  • Council of Architecture (Professional Conduct) Regulations 1989 — Code of Conduct of Architects; advertising; minimum standards.
  • COA Conditions of Engagement and Scale of Charges 2020 — canonical scope of services and fee schedule.
  • Building and Other Construction Workers Act 1996 — worker registration; labour cess.
  • Real Estate (Regulation and Development) Act 2016 — promoter registration; project disclosures.
  • Indian Contract Act 1872 — foundational contract law.
  • National Building Code of India 2016 — Parts 3, 7, 8 — structural, building safety, plumbing, electrical.

Indian Standards Referenced

  • IS 12200 — Code of practice for waterproofing.
  • IS 8543 — Methods of test for waterproofing materials.
  • IS 13182 — Code of practice for waterproof barrier in basements and other places.
  • IS 732 — Code of practice for electrical wiring installations.
  • IS 4963 — Recommendations for buildings and facilities for the physically handicapped.

Voluntary Professional Codes

  • Indian Institute of Interior Designers (IIID) Code of Ethics — voluntary; applies to members.
  • Indian Institute of Architects (IIA) Best Practices Manual — practice guidance for architect members.

Practice Notes and Commentary

  • COA Bulletins — periodic notifications from the Council of Architecture on professional conduct, fee revisions, and disciplinary cases.
  • CREDAI Industry Reports — developer-side perspective on contractor scope and RERA compliance.
  • Construction Law Reporter (Sweet & Maxwell India) — case digests on residential disputes and arbitration awards.
  • Architecture - Time, Space & People — Council of Architecture monthly journal, peer-reviewed editorial board.

Peer-Reviewed Academic References — Indian Construction Practice

The empirical Indian construction-management literature is the strongest source for understanding why boundary-coordination failures recur and how they are most reliably mitigated. The studies below are widely-cited foundations.

  • Iyer, K. C., & Jha, K. N. (2005). Factors affecting cost performance: Evidence from Indian construction projects. International Journal of Project Management, 23(4), 283–295.
  • Doloi, H., Sawhney, A., Iyer, K. C., & Rentala, S. (2012). Analysing factors affecting delays in Indian construction projects. International Journal of Project Management, 30(4), 479–489.
  • Doloi, H. (2013). Cost overruns and failure in project management: Understanding the roles of key stakeholders in construction projects. Journal of Construction Engineering and Management, 139(3), 267–279.
  • Jha, K. N., & Iyer, K. C. (2007). Commitment, coordination, competence and the iron triangle. International Journal of Project Management, 25(5), 527–540.
  • Mahalingam, A., & Levitt, R. E. (2007). Institutional theory as a framework for analyzing conflicts on global projects. Journal of Construction Engineering and Management, 133(7), 517–528.
  • Iyer, K. C., & Jha, K. N. (2006). Critical factors affecting schedule performance: Evidence from Indian construction projects. Journal of Construction Engineering and Management, 132(8), 871–881.

Peer-Reviewed Academic References — Coordination, Dispute & Risk

International scholarship on construction disputes, risk allocation, and coordination — the conceptual basis for the liability matrix and the four contractual patterns in this guide.

  • Mitropoulos, P., & Howell, G. (2001). Model for understanding, preventing, and resolving project disputes. Journal of Construction Engineering and Management, 127(3), 223–231.
  • Cheung, S. O., & Yiu, T. W. (2007). A study of construction mediator tactics. Construction Management and Economics, 25(7), 691–700.
  • Chan, D. W. M., & Kumaraswamy, M. M. (1997). A comparative study of causes of time overruns in Hong Kong construction projects. International Journal of Project Management, 15(1), 55–63.
  • Loosemore, M., & McCarthy, C. S. (2008). Perceptions of contractual risk allocation in construction supply chains. Journal of Professional Issues in Engineering Education and Practice, 134(1), 95–105.
  • Chan, A. P. C., & Chan, A. P. L. (2004). Key performance indicators for measuring construction success. Benchmarking: An International Journal, 11(2), 203–221.
  • Bresnen, M., & Marshall, N. (2000). Partnering in construction: A critical review of issues, problems and dilemmas. Construction Management and Economics, 18(2), 229–237.

Peer-Reviewed Academic References — Interior Design as a Profession

The scholarship anchoring the functional (non-statutory) basis of the interior-design profession and the boundary with architectural practice.

  • Guerin, D. A., & Martin, C. S. (2010). The interior design profession's body of knowledge and its relationship to people's health, safety, and welfare. Journal of Interior Design, 36(2), v–xv.
  • Martin, C. S., & Guerin, D. A. (2006). Using research to inform design solutions. Journal of Facilities Management, 4(3), 167–180.
  • Anderson, B. G., Honey, P. L., & Dudek, M. T. (2007). Interior design's social compact: Key to the quest for professional status. Journal of Interior Design, 33(2), v–xiii.

Standard Treatises and Commentaries

  • Murdoch, J., & Hughes, W. (2015). Construction Contracts: Law and Management (5th ed.). Routledge.
  • Bunni, N. G. (2003). Risk and Insurance in Construction (2nd ed.). Spon Press.
  • Atkin, B., & Borgbrant, J. (Eds.). Performance Improvement in Construction Management. Spon Press.
  • Pollock, F., & Mulla, D. F. The Indian Contract and Specific Relief Acts (current edition). LexisNexis.
  • Hudson, A. A. Hudson's Building and Engineering Contracts (current edition). Sweet & Maxwell.
  • Furst, S., & Ramsey, V. Keating on Construction Contracts (current edition). Sweet & Maxwell.

Indian Legal Periodicals

  • National Law School of India Review (NLSIR) — peer-reviewed law journal; articles on RERA jurisprudence, construction-arbitration enforceability, and Indian Contract Act §73 damages computation in construction disputes.
  • NUJS Law Review (West Bengal NUJS) — peer-reviewed; articles on consumer-protection overlap with RERA in residential transactions.
  • Indian Journal of Arbitration Law (IJAL) — peer-reviewed student-edited journal at NLU Jodhpur; construction-arbitration commentary.
  • Indian Council of Arbitration — ICA Arbitration Quarterly — case digests on Indian construction arbitration awards.

Companion Studio Matrx Guides

See §12 above for the full cross-reference list.


Author's Note: The architect who masters boundary discipline is the architect whose residential practice is sustainable across project sizes, client types, and contractual patterns. Boundary failures are not glamorous — they are not the dramatic structural failures that make news, nor the elegant design moves that win awards. They are the quiet, recurring, fully-preventable disputes that consume project margin, client trust, and professional reputation. The architect's discipline is not to avoid the boundary — interior designers and contractors are essential collaborators whose scopes the architect needs and respects — but to name the boundary, document it, and re-affirm it weekly through the coordination minute book. Boundary discipline is the architect's most underrated competitive advantage in Indian residential practice. The map in this guide is the discipline, and its daily practice — through the coordination meeting, the RFI log, the change-order register, and the engagement-letter scope-clause — is what separates the architect whose projects close cleanly from the architect whose projects close in arbitration.

Disclaimer: This article is for informational and educational purposes only. It does not constitute legal advice or a substitute for engagement-specific contract drafting. The Architects Act 1972, the COA Code of Conduct 1989, the IIID guidelines, and the state-level Builders' Licensing frameworks are subject to amendment and to state-specific notifications. Architects must verify the current text of all referenced statutes and codes at the time of any specific engagement, and engage qualified construction-law counsel for the drafting and negotiation of engagement letters and coordination clauses for projects of significant scale. Studio Matrx, its authors, and contributors accept no liability for decisions based on this guide.

Export this guide
